Ministry of Railways
azadi ka amrit mahotsav

RECORD ALLOCATION TO ODISHA


Rs. 10,012 Crore for Railways in Odisha

प्रविष्टि तिथि: 03 FEB 2023 8:35PM by PIB Bhubaneshwar

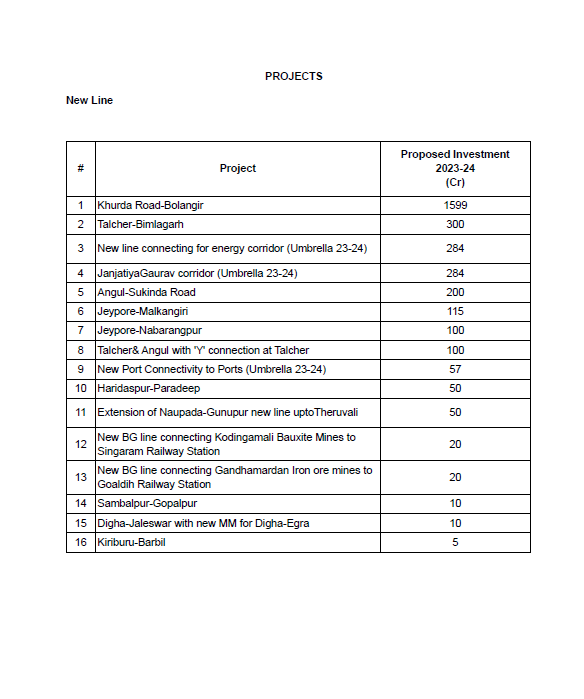

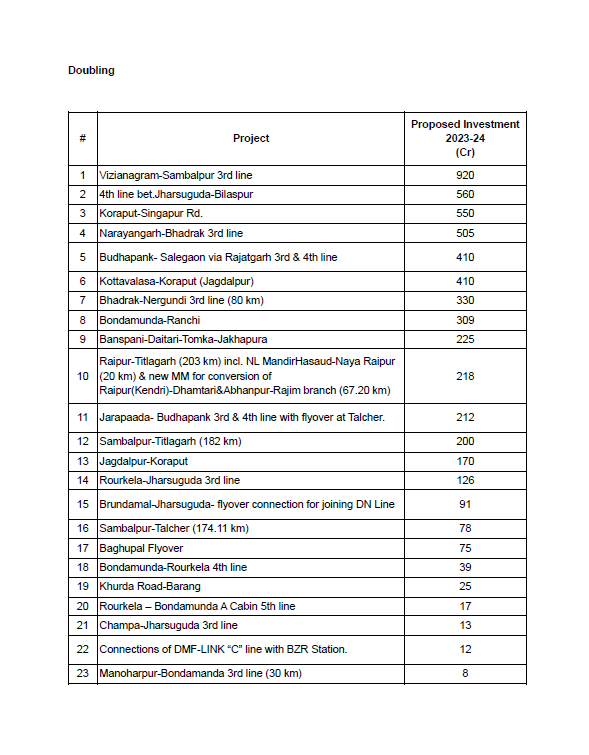

New line/ Doubling / Gauge conversion : 37 projects; 4,643 km; 55,219 Cr

● Budget Allocation:

#

Items

2009-14

2023-24

1

Annual Average Budget Outlay (Rs Cr)

838

10,012 (12 times)



● 284 crores outlay for new Janjatiya Gaurav corridor



● 284 crores outlay for new Energy corridor



● 57 crores for New port connectivity

● Average kms per year in 2022-23 (till Jan-23): 423

● Average kms per year from 2009-14: 53.4

● ROBs/RUBs constructed since 2014: 417

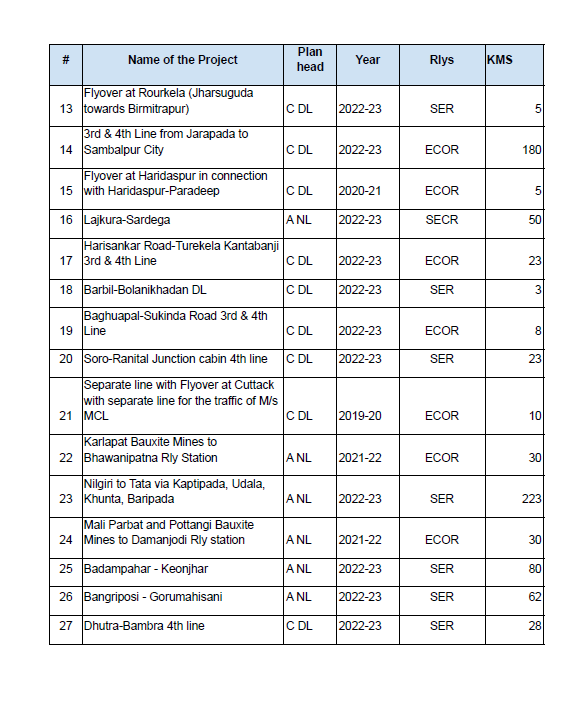

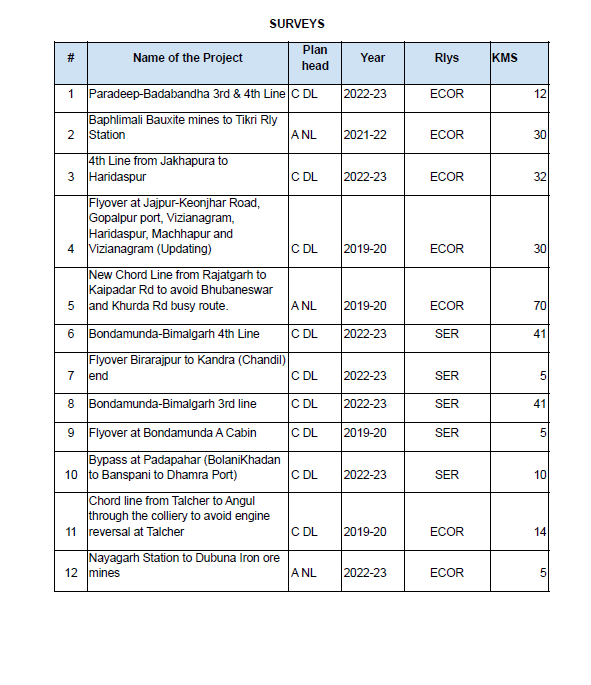

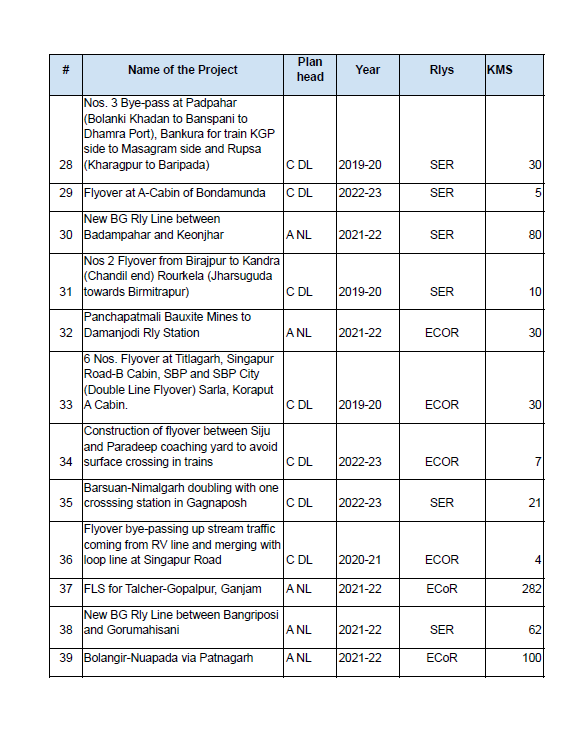

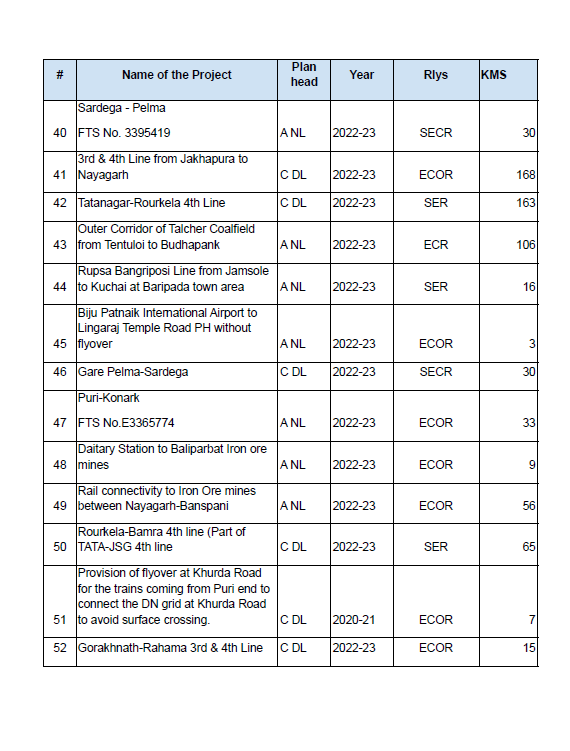

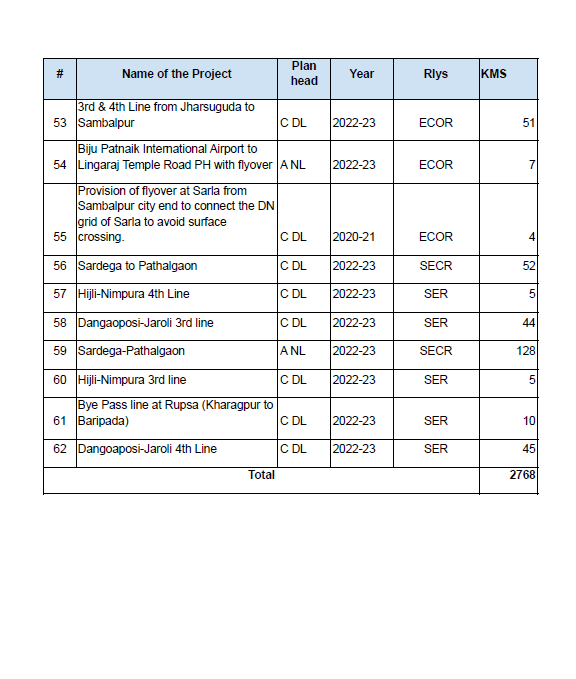

● Ongoing surveys in Odisha ( 62 surveys, 2,768 kms)

● Total Allocation for East Coast Railway: (Including portions of AP, Chhattisgarh & Odisha) : Rs. 11,285.28 Crores.

● OSOP :

#28 stations have been identified under One Station One Product

■ Puri: Pattachitra & Pipili Applique, Sweets

■ Cuttack: Silver Filigree, Handloom, Handicrafts

■ Rourkela: Tribal Products & Vermi-compost

■ Koraput: Kotpad Saree, toys

■ Dhenkanal: Dhokra Casting, Tribal jewellery

■ Sambalpur: Sambalpuri sarees & Garments, Terracotta

■ Titlagarh: Bamboo Art & Craft



Amrit Bharat Station scheme: Odisha ( 57 stations)

#

Station

Cost (Rs. Cr.)

Target date for NIT

Target date for

tender opening

Target date for

tender finalization

1

Puri

162

Tender awarded on 22.072022

Progress:

● Site office and labor camp established

● Site surveys and geotechnical investigations completed

● Demolition of existing structures to create space for the

project started

● Temporary building for ticket counters established

2

Bhubaneshwar

308

Tender awarded on 24.08.2022

Progress:

● Site office established

● Site surveys and geotechnical investigations in progress

● Works of temporary relocation in progress

● New passenger entry/exit walkway work in progress

3

Cuttack

303

06.09.2022

21.10.2022

10.02.2023

Total Cost

773 Cr











Techno-economic feasibility studies in 10 stations started

New Bhubaneswar, Rayagada, Sambalpur, Bhadrak, Brahmapur, Jajpur-Keonjhar Road, Khurda Road, Balasore, Jharsuguda, Rourkela



Work in progress at 27 stations

Dhenkanal, Talcher road, Paradeep, Mancheswar, Kendujhargarh, Koraput, Jeypore, Talcher, Titlagarh Jn, Balangir, Kesinga, Kantabanji, Sambalpur city, Bhawanipatna, Jharsuguda Road, Rairakhol, Paralakhemundi, Baripada, Jaleswar, Rairangpur, Lonawala, Brajrajnagar, Bijnor, Dhampur , Barabil, Angul, Balugaon



57 stations

Angul, Badampahar, Balangir, Balasore, Balugaon, Barbil, Bargarh Road, Baripada, Barpali, Belpahar, Betnoti, Bhadrak, Bhawanipatna, Bhubaneswar, Bimlagarh, Brahmapur, Brajrajnagar, Chatrapur, Cuttack, Damanjodi, Dhenkanal, Gunupur, Harishanker Road, Hirakud, Jajpur-Keonjhar road, Jaleswar, Jaroli, Jeypore, Jharsuguda, Jharsuguda Road, Kantabanji, Kendujhargarh, Kesinga, Khariar Road, Khurda road, Koraput, Lingaraj Temple Road, Mancheswar, Meramandali, Muniguda, New Bhubaneswar, Panposh, Paradeep, Parlakhemundi, Puri, Raghunathpur, Rairakhol, Rairangpur, Rajgangpur, Rayagada, Rourkela, Sakhi Gopal, Sambalpur, Sambalpur city, Talcher, Talcher Road, Titlagarh Jn.



KBK Districts- 13 stations identified for station development:

Titlagarh Jn., Balangir, Kantabanji, Harishankar Road, Kesinga, Bhawanipatna, Rayagada, Muniguda, Gunupur, Koraput, Jeypore, Damanjodi, Khariar Road



Aspirational Districts- 16 stations identified for station development:

Dhenkanal, Meramandali, Paralakhemundi, Kesinga, Bhawanipatna, Koraput, Jeypore, Damanjodi, Rayagada, Muniguda, Gunupur, Khariar Road, Titlagarh Jn., Balangir, Kantabanji, Harishankar Road

Status of USOF schemes in Odisha

● Mobile connectivity in LWE affected areas (LWE-I) : 256 Mobile Towers are radiating out of 261 planned. All radiating sites are being upgraded to 4G

● Mobile connectivity in LWE affected areas-Phase2 (LWE-II) : Out of 483 Mobile Towers planned, 51 Mobile Towers have been commissioned covering 51 Security Sites.

● Uncovered villages of Aspirational Districts of 5 States - Under this project 2379 Mobile Towers have been planned covering 3933 Villages.

● Saturation of 4G mobile services - 2,813 Villages

● BharatNet project - Completed in 6,738 GPs out of 6,792 GPs

● Further, BharatNet will now connect all GPs/ Villages in the Country, including about 13 Villages (Other than GPs) of Odisha

● Total Budget Allocation for 2023-24 : 5,183 Cr



ROM
